What Is the Lead Time for a Custom Coffee Bean Order from BeanofCoffee?

What Is the Lead Time for a Custom Coffee Bean Order from BeanofCoffee?

I remember a call from a roaster in Seattle. He was excited. He had just landed a big wholesale account. He needed his custom blend—a specific 70/30 mix of our washed and natural Arabica—in his warehouse by September 1st for the fall menu launch. He called me in August. I had to tell him the truth. It was not possible. The coffee was in Baoshan. The vessel took 18 days. Customs took a week. We had missed the window. He had to scramble and buy expensive spot market coffee to fill the gap. The pain in his voice was real. He had not accounted for the full lead time.

The lead time for a custom coffee bean order from BeanofCoffee is typically 8 to 12 weeks from the date of contract signing and specification approval to the vessel departure from Shanghai, with an additional 3 to 5 weeks for ocean transit and customs clearance to a U.S. port, meaning buyers should plan for a total door-to-door timeline of approximately 12 to 16 weeks.

This is not a delay tactic. This is the reality of preparing a high-quality, traceable, custom product from a single estate. You are not buying beans off a shelf. You are commissioning a production run. Let me walk you through the calendar so you can plan your inventory with confidence and never miss a menu launch again.

What Are the Key Stages That Determine Custom Order Lead Time?

The lead time clock starts ticking the moment you sign the contract and approve the final specification sheet. Before that, we are in the exploration and sampling phase, which has its own timeline. But once the order is booked, the real work begins.

The key stages that determine custom order lead time are: (1) final green coffee selection and allocation from our warehouse inventory, (2) dry milling and density sorting to the exact specifications, (3) the custom blending and homogenization process, (4) quality control, cupping, and Pre-Shipment Sample (PSS) approval, and (5) final bagging, container stuffing, and documentation.

Each of these stages requires a specific number of days. Rushing any of them compromises the quality and consistency of your custom blend. We will not do that.

How Long Does the Green Bean Allocation and Preparation Take?

This is the first step after the contract is signed. You have specified a blend of 70% washed Grade 1 Arabica from our 1,600m block and 30% natural Catimor from our 1,450m block. We need to physically allocate that coffee to your order.

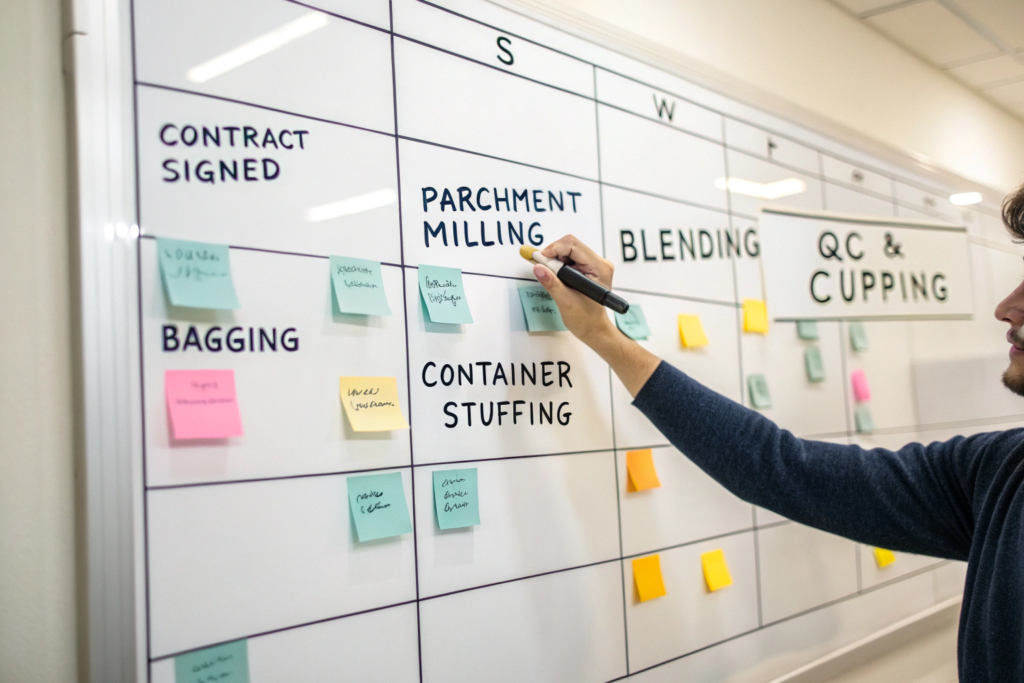

The Process and Timeline:

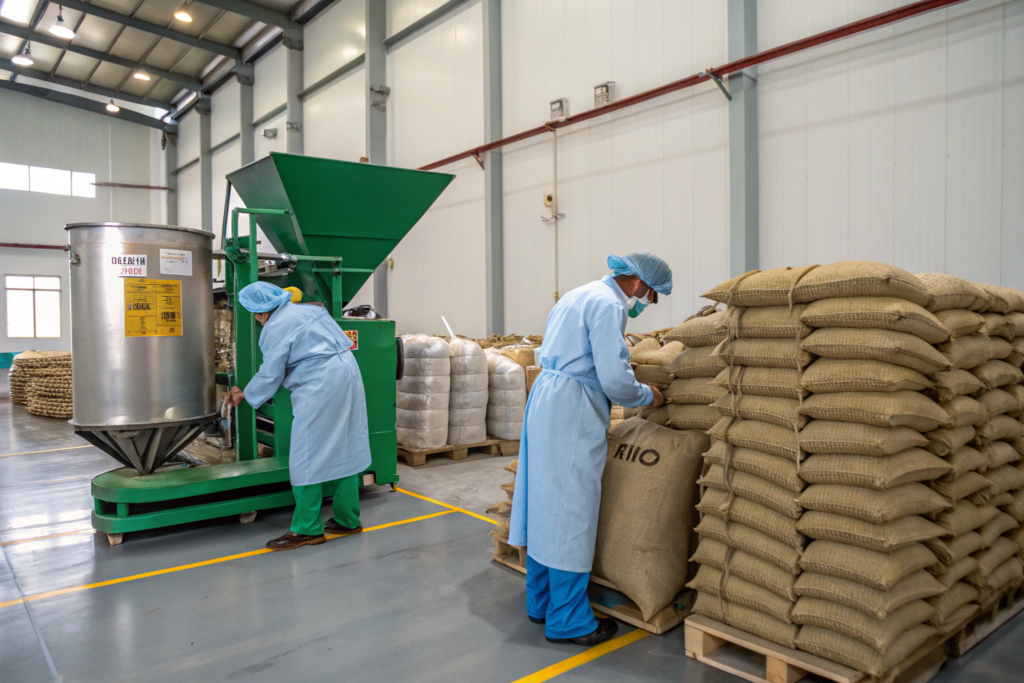

  1. Inventory Check & Reservation: Our logistics team checks the real-time inventory of the specific lots you have chosen. We confirm the available volume in our parchment warehouse. We then reserve that specific volume for your order in our system. This prevents it from being sold to another client. Timeline: 2-3 business days.
  2. Parchment Retrieval & Staging: The selected parchment coffee is retrieved from our cool, high-altitude storage and moved to the dry mill staging area. It needs to acclimate to the ambient temperature for 24-48 hours before milling to prevent condensation issues. Timeline: 3-5 business days.
  3. Dry Milling & Density Sorting: This is the physical transformation. The parchment is hulled, and the green beans are run through our sizing graders and gravity separators to meet your exact screen size and density specifications. As we discussed, this is slower for specialty grades. Timeline: 5-7 business days.

This initial stage typically takes 2 to 3 weeks from contract signing to having the finished green coffee components ready for blending. This is the foundational work. You cannot skip it. At Shanghai Fumao, we do not pre-mill large volumes of coffee to sit in a warehouse. We mill to order to ensure maximum freshness. For more on inventory management, resources from the Association for Supply Chain Management provide industry best practices.

What Is the Timeline for Custom Blending and Homogenization?

Once the individual components are milled and QC-approved, we move to the blending stage. This is where your unique recipe comes to life.

The Blending Process & Timeline:

  1. Ribbon Blender Scheduling: Our 5-ton industrial ribbon blender is a shared resource. We schedule blending runs based on order priority. During peak season (June-October), there may be a queue of 3-5 days. Timeline: 3-7 business days to get on the schedule.
  2. Weighing and Loading: The components are weighed precisely according to your approved ratio (e.g., 70% Component A, 30% Component B). This is a critical, audited step. Timeline: 1 day.
  3. Mixing Cycle: The coffee is gently tumbled in the blender for 20-30 minutes to achieve a perfectly homogeneous mix. Timeline: Included in the blending day.
  4. Post-Blend QC and Resting: After blending, our Q-Grader takes samples from the top, middle, and bottom of the batch. These are roasted and cupped to verify that the blend is uniform and matches the approved flavor profile. The blended coffee is then allowed to rest in a climate-controlled bin for 24-48 hours to allow the moisture and water activity to equilibrate across the different components. This is a subtle but important step for roast consistency. Timeline: 2-3 business days.

The blending and homogenization stage adds 1.5 to 2.5 weeks to the lead time. This is the value-add of a custom order. This is where we do the work for you so you receive a single, ready-to-roast product.

How Does the Pre-Shipment Sample Approval Impact the Timeline?

This is the most important quality gate in the entire process. It is also the point where the timeline is most dependent on you, the buyer. We cannot move forward without your explicit approval.

The Pre-Shipment Sample (PSS) approval process adds approximately 1.5 to 3 weeks to the lead time, which includes the time for our Q-Grader to roast and evaluate the blend sample, the express courier shipping time to your location (typically 3-5 business days), and the time you require to cup, evaluate, and provide written approval for the shipment.

This step is non-negotiable for custom orders. It protects both of us. It ensures that the coffee we bag and ship is the coffee you expect.

What Is the Protocol for Cupping and Approving the PSS?

We do not just send you a sample and hope for the best. We follow a structured protocol to make the process efficient.

Our PSS Protocol for Custom Blends:

  1. Internal QC First: Before we even send the sample, our in-house Q-Grader cups the post-blend sample. It must meet the internal specification and the agreed-upon cup score (e.g., 84+). If it fails internally, we do not waste your time. We adjust the blend or the roast and re-submit internally. Timeline: 1-2 days.
  2. Sample Roasting and Packaging: We roast a 500g sample of the final blend on our sample roaster to the exact Agtron specification you provided in the contract (e.g., Agtron Ground 55). We package it in a valve bag and seal it. Timeline: 1 day.
  3. Express Courier Shipping: The sample is shipped via DHL or FedEx. Transit time to major U.S. cities is typically 3-5 business days. We provide you with the tracking number immediately.
  4. Your Evaluation Window: We ask that you prioritize the cupping of the PSS upon arrival. We recommend a 3-5 business day evaluation window. This gives you time to cup it, brew it, and possibly even pull shots.
  5. Written Approval: You send a simple email to Cathy: "PSS for Contract #BOC-26-XX Approved. Please proceed with bagging and shipment."

The total time for this stage is typically 10-15 business days. If you delay your evaluation, the shipment is delayed. Clear communication on timing expectations is key. At Shanghai Fumao, Cathy will proactively email you when the sample ships and gently follow up if we have not heard back within a week.

What Happens If the PSS Requires a Roast Adjustment?

This is a scenario we hope to avoid, but it is a reality of custom work. What if you cup the PSS and say, "It is good, but can we get a touch more development? It is a little sour for my espresso application."

The Adjustment Process:

  1. Feedback Loop: You provide specific, actionable feedback. "The body is great, but I need the acidity to be slightly softer. Can we extend the development time ratio on the sample roast by 2%?"
  2. Re-Roast and Re-Ship: Our Q-Grader adjusts the sample roast profile according to your feedback. We roast a new 500g sample and ship it to you. Timeline: +5-7 business days.
  3. Re-Evaluation: You cup the new sample.

Important Note: This adjustment applies to the sample roast profile, not the green coffee blend itself (unless the issue is with the blend ratio, which is rare). The green coffee is already milled and blended. The adjustment is to how we are roasting the evaluation sample to simulate your production environment.

This is why we encourage you to provide very clear roast specifications in the initial contract. The more precise you are upfront, the less likely we are to need a time-consuming adjustment loop. Providing us with a target Agtron number and a preferred development time ratio is the best way to ensure a first-time approval.

What Is the Final Processing and Logistics Window Before Sailing?

You have sent the approval email. The green light is on. Now we move into the final execution phase. This is where our operational capacity and logistics expertise come into play. The clock is ticking toward the vessel cut-off date.

The final processing and logistics window, from PSS approval to vessel departure, typically takes 7 to 12 business days, encompassing the bagging and sealing of the custom blend, the application of your specified private labels or markings, the completion of export documentation, the inland trucking to the port of Shanghai, and the final delivery of the container to the terminal before the cut-off time.

This is a fast-paced, tightly choreographed sequence. There is no slack in this part of the schedule.

How Long Does Bagging, Labeling, and Container Stuffing Take?

Once we have your approval, we schedule the final bagging run.

The Bagging and Stuffing Timeline:

  • Bagging & Sealing: The blended green coffee is fed into our automated bagging line. It fills 60kg jute bags (with GrainPro liners) at a rate of approximately one bag per minute. For a full container (320 bags), the bagging process takes 6-8 hours of machine time. Timeline: 1-2 business days (including setup and cleanup).
  • Labeling & Palletizing: As the bags are filled, they are stenciled with the required markings (Lot Number, Destination, etc.) and your custom private label, if applicable. They are stacked onto pallets. Timeline: Occurs concurrently with bagging.
  • Container Stuffing: A dedicated 20-foot container is delivered to our loading dock. Our team carefully loads the 320 bags into the container, ensuring the weight is evenly distributed. The container is sealed with a high-security bolt seal. The seal number is recorded. Timeline: 3-4 hours on the scheduled day.
  • Final Documentation: While the container is being stuffed, our logistics team finalizes the export documentation package (Commercial Invoice, Packing List, Phyto Certificate, etc.) based on the final, actual weights. Timeline: 1 business day.

This entire sequence, from approval to a sealed, documented container ready for trucking, takes 3 to 5 business days. At Shanghai Fumao, this is a core competency. We do this every week.

What Are the Inland Transit and Port Cut-Off Timelines to Shanghai?

The container is sealed at our mill. But it is still 2,700 kilometers from the ocean. The inland journey is the final leg of our responsibility under FOB terms.

Inland Logistics Timeline:

  • Truck Booking: We book the dedicated truck 48 hours in advance of the stuffing date. Timeline: Handled in parallel.
  • Inland Transit (Baoshan to Shanghai): The truck drives day and night. The journey on the G56 and G60 expressways takes 3 to 4 days. We track the truck via GPS in real-time.
  • Port Cut-Off: This is the critical deadline. The shipping line specifies a "Cut-Off" date and time by which the container must be physically inside the terminal gate. This is typically 48-72 hours before the vessel's scheduled departure.
  • Buffer Time: We always build in a 1-2 day buffer between the planned arrival of the truck and the port cut-off. This buffer absorbs minor traffic delays, tire changes, or weather issues.

Example Timeline:

  • Day 1: Container stuffed and sealed.
  • Day 2-5: Truck in transit to Shanghai.
  • Day 5: Container arrives at terminal gate, 2 days before cut-off. Success.

Missing the cut-off means the container "rolls" to the next vessel, which can add 7-10 days to the transit time. Our entire logistics operation is designed to prevent this. Cathy monitors the truck's progress and communicates with the terminal to ensure a smooth gate-in. For real-time information on Shanghai port conditions, resources like SeaRates port congestion tool can provide insights.

How Can a Roaster Plan Their Annual Calendar Around These Lead Times?

You have the breakdown of the timeline. Now you need to translate this into your own business calendar. The key to stress-free custom sourcing is backward planning. Start with the date you need the coffee on your shelf and work backward.

Roasters should plan their annual calendar by identifying the target "On-Shelf" date for the custom coffee, then subtracting 4 weeks for ocean transit and domestic logistics, then subtracting the 12-week BeanofCoffee production lead time, to arrive at the required "Contract Signing" date, which for a September launch means placing the order no later than late April or early May.

This is a six-month planning horizon. This is the discipline of professional coffee sourcing.

If I Need Coffee for a September Launch, When Do I Book?

Let's run a precise scenario. This is the calculation you should do for every seasonal blend or new product launch.

Target: Custom Blend "Harvest Moon" on Roastery Shelf by September 1st.

Step Activity Duration Calendar Date (Backward)
Target Date Coffee Available for Roasting - September 1
Step 1 Domestic Trucking & Warehousing 1 Week August 25
Step 2 US Customs Clearance & Port Release 1 Week August 18
Step 3 Ocean Transit (Shanghai to USWC) 3 Weeks July 28
Step 4 Buffer for Port Delays / Rolling 1 Week July 21
Step 5 Vessel Departure Shanghai (Target) - July 14
Step 6 Inland Trucking & Port Cut-Off 1 Week July 7
Step 7 Bagging, Stuffing, Documentation 1 Week June 30
Step 8 PSS Approval & Feedback Loop 2 Weeks June 16
Step 9 Blending, QC, and PSS Shipment 2 Weeks June 2
Step 10 Green Bean Milling & Allocation 3 Weeks May 12
Step 11 Contract Finalization & Spec Approval 1 Week May 5
Recommended Action Date Initial Inquiry & Sample Requests - March - April

The Verdict: To have custom blend coffee on your shelf by September 1st, your contract needs to be signed and the specification sheet finalized by the first week of May. This means you should be cupping samples and negotiating the blend ratio in March and April.

This is the reality. If you contact me in July for a September launch, I will do my best, but it will be tight and stressful. If you contact me in March, it will be smooth and predictable. At Shanghai Fumao, we work with our long-term partners to map out these calendars annually. We want to be a reliable part of your planning cycle.

Can I Reserve Production Capacity for a Future Custom Order?

Yes. And this is the best way to ensure your timelines are met, especially for large or complex orders. We offer a Production Capacity Reservation for our contracted clients.

How It Works:

  • Non-Binding Forecast: You provide us with a non-binding forecast of your expected custom blend volume for the upcoming crop year (e.g., "We anticipate needing 5 containers of our custom espresso blend between July and December 2026").
  • Capacity Allocation: Based on this forecast, we tentatively reserve milling and blending capacity for you in our production schedule.
  • Firm Booking: 60-90 days before your desired ship date, you convert the forecast into a firm Purchase Order with final volumes and specifications.
  • Guaranteed Slot: Because you reserved the capacity, your order gets priority scheduling. You avoid the peak-season queue.

This is a partnership model. It gives you security of supply and preferred scheduling. It gives us visibility into future demand so we can manage our operations efficiently. It is how we work with our most valued long-term clients.

Conclusion

The lead time for a custom coffee bean order from BeanofCoffee is a function of our commitment to quality and transparency. The 12-16 week door-to-door timeline is not a sign of inefficiency. It is the time required to mill, blend, QC, approve, bag, and ship a truly custom, traceable, high-quality product from a single estate in Yunnan to your roastery door.

By understanding the stages—from green bean allocation to PSS approval to the final stuffing—you can plan your sourcing calendar with precision. You can avoid the panic of last-minute orders and the cost of spot-market replacements. You can launch your seasonal blends with confidence. The key is to plan backward and communicate early. We are here to help you build that calendar.

If you are starting to plan your custom blend needs for the upcoming season, let's talk about the timeline. We can map out a schedule that works for your launch dates. Email Cathy Cai. Tell her your target launch date, and she can work backward to provide you with a recommended "Order By" date. Contact Cathy at: cathy@beanofcoffee.com
